Each project has its own main work schedule. This is where standard hours of work for the project and where project specific non-working days and project specific non-standard work hours are set up.

This project work schedule can then be used to schedule tasks.

If no resource is assigned to a task, then the project work schedule is always used to schedule that task. Otherwise the work calendar setting for the resource is used to schedule the task (that could be to use the project work schedule or the user work schedule or a custom work schedule).

A project work schedule will inherit the settings from a default work schedule. It can then be edited for that specific project.

For more information, see Work Schedules.

Overview of Project Work Schedules

Each time a resource is assigned to a project, there is a setting for that resource that controls which work schedule to use. See Add Resources to Projects.

If it is set to use the project default work schedule then the project specific work schedule will be used for scheduling tasks for that user.

A project work schedule defines the standard work days, holidays, shutdown and non-standard working times specific to the project. For example, maybe all staff assigned to the project are going to work 10 hour days - 4 days a week. You can create a project schedule to reflect that.

Each project work schedule will be based on a PI Default Work Schedule(s). Default Work Schedules can be set up by your system administrator to track all the organization wide holidays, shutdown times, other non-working times and non-standard work hours. When you add a project, you specify which default work schedule it will inherit from. The information from that default work schedule is pulled automatically into the project work schedule so it doesn't have to be re-entered each time for each individual project. Project specific information can then be added.

In the work schedule add/edit form for a project, the default work calendar applied to them will be displayed at the top of the Default Workdays tab. The information will be populated with the data from the default work schedule but then can be changed.

Note* the project holidays, shutdown days, any other non-working time or non-standard work time over-ride any settings in the default work schedules if there is a conflict. For example, the default work schedule has a company wide holiday set for December 25th. The project work schedule can be edited and December 25th set as a work day for that specific project (maybe this is a support project and requires staff to be working on holidays). That would over-ride the holiday setting in the default work schedule and schedule the user to work that day.

Who can Edit a Project Work Schedule

Project Managers, Project Schedulers as well as PMO Managers can edit the Project Work Schedule.

To edit a project work schedule,

  • Display the project
  • Hover on the Views menu option
  • Choose Work Schedule

The work schedule add/edit form appears

Project Work Schedule - Add/Edit Form

There are two tabs that will always show on the project work schedule add/edit form:
  • Default Workdays
  • Holidays, Non-Workdays and Special Days

A third tab may show depending if there are holidays, shutdowns, non-working days or non-default times entered in the default work schedule associated with this work schedule.

  • Inherited Days

Default Workdays

This is where you set the default hours of work for each week for this specific project.

It will be initially populated with the details from the default work schedule. It may be left as the defaults or changed as required.

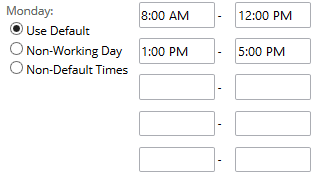

The work schedule form shows each day of the week (Monday through Sunday) and options associated with that day:

Start and Stop Working Times

First, there is space for each day to enter up to 5 different stop and start times throughout the day. For the majority of organizations, having 2 stop and start times is most common, i.e. the time you work before lunch and then the time you work after. The example below illustrates this. It indicates that work starts at 8 am and goes for 4 hours until 12 pm. Then there is 1 hour of non-working time (lunch), then work starts again at 1 pm and goes to 5 pm for another 4 hours of work. The remaining three start and stop times are just left blank because they aren't applicable.

As indicated, for the majority of most organizations - 2 start and stop times for a day provides detailed enough scheduling, however, you may change the hours indicated to reflect their company. For example, a company generally works a 7.5 hour day instead of an 8 hour day and they just take 1/2 hour for lunch. So instead of starting at 8 am, they start at 8:30 am and the afternoon work time starts at 12:30 until 4:30.

In that case, the start and stop times would be changed to the following:

If you did have requirements for tighter time controls, then you can enter those. For example, it is an 8 hour work day with 1 hour lunch but there are also 2 - 15 minute coffee breaks included in that 8 hours. So really, the team is productive or doing work only 7.5 hours. In this case, you would have 4 start and stop times entered.

or scheduling and the times are displayed and visible to anyone looking at the task so they do have to make sense for your organization.

The reason that the start and stop times are important is that they are used for scheduling and the times are displayed and visible to anyone looking at the task so they do have to make sense for your organization.

For example, if you worked an 8 hour day, you could just put in one start and stop entry for 8 hours, such as 8 am to 4 pm. Tasks would be scheduled to end at 4 pm and that time would show on tasks. Your scheduling would be correct in terms of hours because Project Insight knows its an 8 hours work day, but stakeholders might get confused seeing end times of 4 pm when staff really do work until 4:30 or 5 pm.

So it is recommended that you enter in accommodations for lunch breaks (as outlined above), to get as close to possible as staff are actually working and not just enter in a continuous day with no start and stop times.

Use Default, Non-Working Day, Non-Default Times Settings

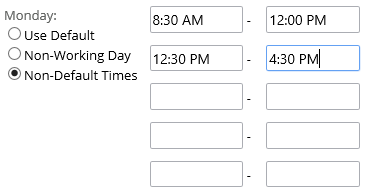

For each day of the week, there are radio buttons which indicate if the times for that day are Using the Default times, it is a non-working day or it is a working day but it is not using the default start and stop times.

These radio buttons have different meanings depending on which work schedule you are editing.

These radio buttons will be set automatically by the system depending on what you enter, but you can also set them manually.

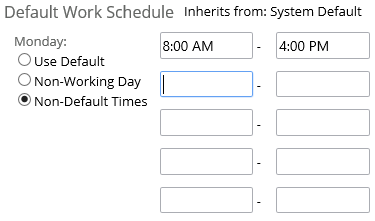

  • System wide default work schedules - In the back-end functionality of Project Insight that you don't see, there are default start and stop times set for each day of the week. Monday to Friday has an 8 am to 12 pm start and stop time and a 1 pm to 5 pm start and stop time (for an 8 hour work day). Then there is no work start and stop times for Saturday and Sunday as those days aren't usually work days for a large majority of companies. When you are editing default work schedules, and the radio button is set to Use Default it means to use those back-end default start and stop times (and those are what are displayed). If you change the start and stop times to something other than that, then by default that day will be categorized as a non-default time setting. If you remove the start and stop times entirely for the day, then it will be categorized as a non-working day. You don't necessarily need to be concerned about these settings. For you, they are informational only however Project Insight does use those settings in the back-end though to calculate task schedules quicker and easier.
  • Individual user specific work schedules - For each user, you set the default work schedule that their individual schedule gets data from, then you can change it. The Use Default radio button indicates that it is using the default work schedule for that day from the default work schedule. If you change the start and stop times to something other than that, then by default that day will be categorized as a non-default time setting. If you remove the start and stop times entirely for the day, then it will be categorized as a non-working day. Again, this is informational only for you.
  • Project specific work schedules - For the project calendars, it is the same as the Users. For each project, you set the work schedule that the project work schedule inherits data from. If you leave that, it is set as Use Default. If you change it, then it switches to either the non-working day or non-default times setting.

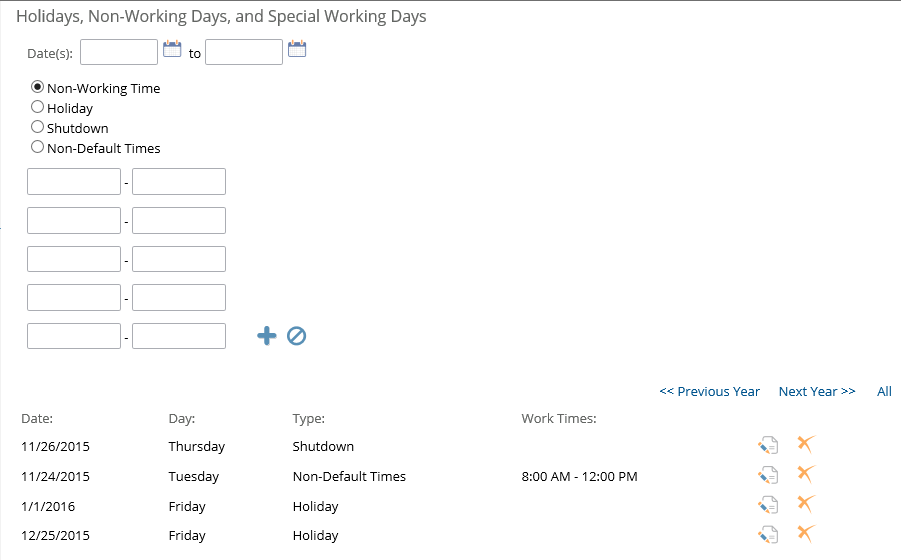

Holidays, Non-Workdays and Special Days

This is where the user specific vacation days, PTO, Leave of Absence or any other non-working days or non-standard work days are entered.

This needs to be maintained on a yearly basis.

To add a Non-Working, Time or Holiday, etc.:

  • In the first date entry field, enter the start date of the non-working time, holiday, shutdown or non-default working times. Type in the date (a hint will appear with the date format and some shortcut keys for entering dates when you click in the field) or click the Calendar icon to select it.
  • The To Date will be automatically populated with the same date when you tab or move out of the first date entry field. If you are entering only one day, then just leave it the same. If you are entering multiple consecutive days of holiday, non-working time etc. then enter the To date. Type in the date or click the Calendar icon to select it.
  • If it is a non-working day, categorize it by clicking on the available options.
    • If you are entering the PI Default Work Schedule(s) or a Project Work Schedule, the options are Non-Working Time, Holiday or Shutdown.
    • If you are entering a User Work Schedule, the options are Non-Working Time, Vacation, PTO, Leave of Absence).
    • See the section below for how the categories are used.
    • Click on the appropriate option.
  • If it is a working day, but the times for that day are different than the defaults you set up on the Default Work Days tab, click on the Non-Default Times category.
    • The spaces for entering the stop and start times for the day become available.
    • Enter in the special working times for that day. For example, if it is a half day instead of a full day, enter 8 am to start and 12 pm to end.
  • Click the Add icon (the blue + sign) to store this entry. It will be listed in the section below the data entry boxes. NOTE* This is not yet saved in the database. This is just creating a working list of holidays. Do not move off this form until you actually it.
  • Continue adding any other holidays, vacation or other non-working days and special days as required.

Recalculate Schedules

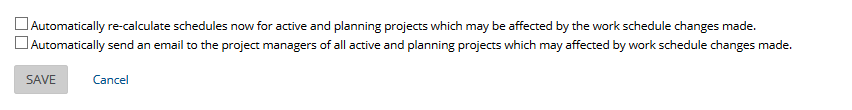

  • When you are done maintaining the holidays, there is an option to immediately recalculate schedules for active and planning projects that are effected by these changes. Check on this option to turn it on. Alternatively, if you don't do this now, schedules will still be re-calculated automatically to incorporate the changes on the following conditions:
    • A task is edited - the change will then be applied.
    • A task is updated by another function - such as Updating Rates (from the Resources menu option) or forcing immediate planned and earned value calculations from the Project Status tabs Budget and Performance.
    • The Project Settings to Capture Active Project History Nightly has been set with a time. The project schedule will be updated automatically when that function runs at that designated time.
  • If you do choose to update the schedules immediately, then there is also another option to notify the project managers of any project schedules that are changed. Check on this option to turn it on. It is a good idea to notify the project managers, especially if you don't have any other automatic notification in place that would communicate this.
  • Click to save the changes and optionally update any planning and active projects that are effected.

If a System Administrator, User Manager or default time sheet approver changes the User Work Schedule, they have the option to re-calculate schedules immediately for active and planning projects which may be affected by the work schedule changes made. They can also optionally email project managers of any updates to their projects. These options are found on the Holidays, Non-Working Days, and Special Working Days tab.

If a user changes their work schedule or the System Administrator, User Manager or default time sheet approver didn't choose to re-calculate scheduled immediately, then a task with the schedule changes when the following happens:

  • A task is edited - the change will then be applied.
  • A task is updated by another function - such as Updating Rates (from the Resources menu option) or forcing immediate planned and earned value calculations from the Project Status tabs Budget and Performance.
  • The Project Settings to Capture Active Project History Nightly has been set with a time. The project schedule will be updated automatically when that function runs at that designated time.

Display of Holidays, Shutdown, Vacation, PTO, etc.

Once holidays, shutdown days, vacation, PTO, or any other non-working or non-standard working days are entered and saved, the current year ones will show by default on the same form.

To see other years,

  • Click the Previous Year text
  • Click the Next Year text
  • Continue clicking on those options as required to see the corresponding days
  • Click All to see all years together

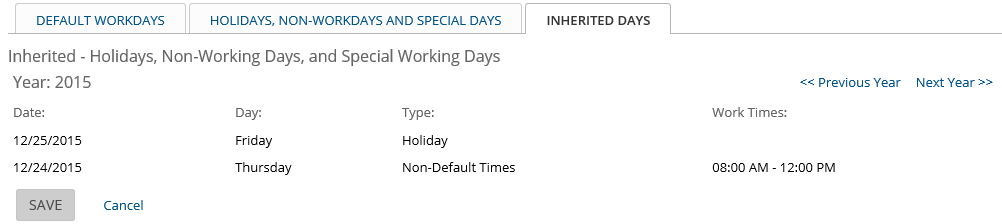

Viewing Inherited Vacation etc. for a Project or User Work schedule

If this is a project or user work schedule, then only the holidays, vacation, etc. that is set specifically for that user or project appear on the Holidays, Non-work Days and Special Days tab. To see the holidays, set up in the default calendar associated with this user, click on the Inherited Days tab.

Navigate through this display the same way by clicking on Previous Year, Next Year or All text.

Effects of Changing a Project Work Schedule

If you change a projects work schedule, the schedule will be updated automatically for any resources set to use the Project Default work schedule as soon as you save the changes.
Online 10/31/2016
